Dubai’s commercial real estate landscape is among the most dynamic in the world. From the gleaming towers of the DIFC to the industrial corridors of Al Quoz, thousands of businesses transform raw shell spaces into high-performing workplaces every year. Yet without a structured office fit-out checklist, even the most ambitious office renovation UAE project can spiral into budget overruns, authority rejections, and costly delays.
This authoritative guide developed with insights drawn from decades of commercial fit-out experience across the UAE walks you through every critical stage of the process: from initial briefing and authority approvals to MEP coordination, IT infrastructure, ergonomic workspace planning Dubai, and final handover. Whether you are a start-up fitting out 200 sq ft of co-working space or a multinational corporation executing a Category B commercial fit-out Dubai across three floors, this checklist is your blueprint.
Read every section carefully. Bookmark it, share it with your project team, and use it as a living reference document. By the time you reach the FAQ and the CTA at the bottom, you will have the clarity and confidence to deliver your office setup UAE on time, on budget, and most importantly exactly as you envisioned.
Pro Insight: Dubai’s premium business districts (DIFC, Dubai Design District, Downtown) typically command Category B fit-out costs of AED 350–600 per sq ft, while Abu Dhabi and secondary Dubai zones average AED 180–320 per sq ft — always benchmark before signing your lease.

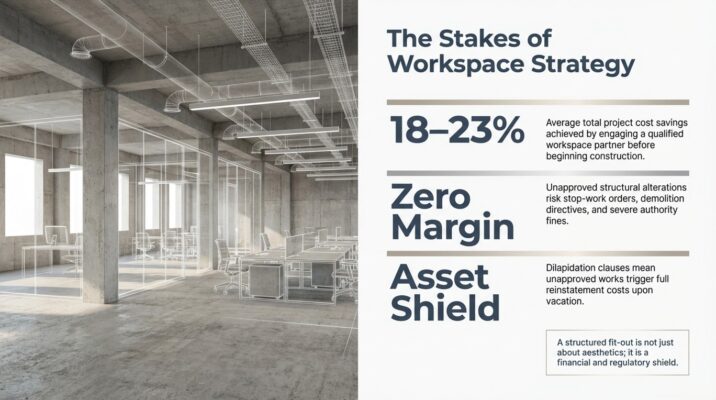

1. Why a Structured Fit-Out Checklist Is Non-Negotiable in Dubai
The UAE’s regulatory environment is precise and, in many cases, unique globally. Dubai Municipality (DM), the Dubai Development Authority (DDA), Trakhees, and free-zone specific authorities each maintain distinct approval pathways. A missed NOC or an unapproved structural alteration can result in stop-work orders, demolition directives, and fines that dwarf the original fit-out budget.
Beyond compliance, structured planning directly influences your return on investment. Research by CBRE (Middle East) consistently shows that organizations that engage a qualified workspace planning Dubai partner from day one save an average of 18–23% on total project costs compared with those who begin construction before completing design and approval cycles.
A comprehensive office design checklist UAE also protects the landlord relationship. Most UAE lease agreements include dilapidation clauses, meaning unapproved alterations can trigger full reinstatement costs upon vacation. Planning well from the outset preserves both your deposit and your reputation as a commercial tenant.

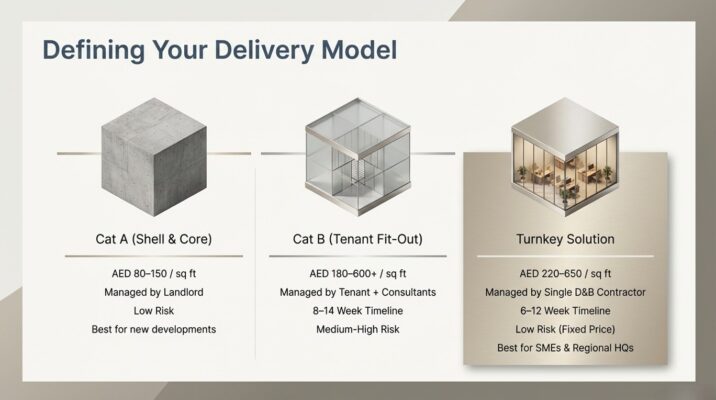

2. Understanding the Three Types of Office Fit-Out in Dubai
2.1 Category A (Shell & Core to Basic)
Category A fit-out transforms a raw shell-and-core unit into a lettable space. It typically includes raised access floors, suspended ceilings, basic mechanical and electrical distribution, fire detection systems, and toilet facilities. Landlords usually bear the cost of Category A works, or they may offer a fit-out contribution (FOC) incentive to attract quality tenants.
2.2 Category B (Tenant Fit-Out)
This is the primary focus of most businesses. Category B covers everything a company needs to be operational: partitioned meeting rooms, feature reception areas, branded design elements, custom joinery, specialist lighting, IT infrastructure, kitchen and breakout zones, and the selection of office furniture tailored to the brand identity. This is where the bulk of your office fit-out checklist applies.
2.3 Turnkey Office Solutions Dubai
A growing preference among UAE businesses particularly SMEs and regional headquarters is the turnkey model. Here, a single design-and-build firm handles everything from conceptual design to furniture procurement, authority approvals, construction, IT cabling, and final handover. Turnkey office solutions Dubai significantly reduce the project management burden on internal stakeholders and offer fixed-price certainty. OfficeMaster.ae specializes in delivering turnkey office solutions across Dubai, Sharjah, Abu Dhabi, and the UAE Northern Emirates.

Fit-Out Type Comparison
| Factor | Shell & Core (Cat A) | Category B Fit-Out | Turnkey Solution |
|---|---|---|---|
| Who manages it? | Landlord / Developer | Tenant with consultants | Single D&B contractor |
| Typical AED cost / sq ft | AED 80–150 | AED 180–600+ | AED 220–650 (all-in) |
| Design involvement | Minimal | High — tenant driven | Full service |
| Timeline (500 sq ft) | Pre-delivered | 8–14 weeks | 6–12 weeks |
| Authority approvals | Landlord-managed | Tenant-managed | Contractor-managed |
| Risk level | Low | Medium–High | Low (contractually fixed) |
| Best for | New developments | Established businesses | SMEs, start-ups, HQs |
3. The Master Office Fit-Out Checklist — Phase by Phase
Use this as a project governance framework. Each phase must be signed off before the next begins. Skipping phases is the single most common cause of cost overruns in commercial fit-out Dubai projects.
Phase 1 — Discovery & Briefing (Weeks 1–2)
- Define your head count, departmental structure, and 3–5 year growth projections
- Establish a realistic budget envelope (construction, furniture, FF&E, IT, contingency)
- Appoint a project lead internally to be the single point of contact
- Conduct a lease review — identify landlord obligations, FOC allowance, reinstatement clauses
- Survey the existing space: structural grid, slab-to-slab height, existing MEP distribution, loading capacity
- Identify authority jurisdiction: Dubai Municipality, Trakhees, DIFC Authority, DDA, Tecom, JAFZA, DAFZA, etc.
- Shortlist and issue RFP to 3–5 qualified commercial fit-out Dubai contractors
Phase 2 — Design & Space Planning (Weeks 2–5)
- Receive and evaluate concept design proposals from shortlisted contractors
- Agree on a design direction: open plan, cellular, hybrid agile, or branded executive
- Complete a detailed space programmed per department (see Space Allocation Table below)
- Confirm furniture strategy — standard ergonomic workstations vs. bespoke joinery vs. procurement of branded office furniture Dubai collections
- Design sign-off on floor plans, elevations, material finishes, color palette, and lighting zones
- Coordinate specialist disciplines: IT cabling, AV integration, access control, security CCTV
- Agree MEP design with a qualified MEP consultant aligned to DEWA / Empower / Etisalat regulations
Phase 3 — Authority Approvals (Weeks 4–8)
- Submit for Dubai Municipality NOC (or relevant free-zone authority)
- Obtain Civil Defense (CD) fit-out approval — fire suppression, smoke detection, emergency lighting
- DEWA approval for electrical load modifications and new panels
- Telecom permit from du or Etisalat for structured cabling works
- Trakhees (for DP World zones) — building NOC and fit-out permit
- Landlord / Building Management NOC for works commencement
- Structural NOC if any slab penetrations or load-bearing elements are altered
- Apply for site hoardings and hoisting permits if heavy goods deliveries are planned
Phase 4 — Procurement & Pre-Construction (Weeks 5–9)
- Award main contract — signed and insurance certificates in place
- Issue purchase orders for long-lead items: glass partitions, bespoke joinery, imported office furniture
- Order materials: ceiling tiles, raised floor, wall finishes, flooring, lighting fixtures
- Mobilize site: hoarding, welfare facilities, material storage, site induction
- Finalize MEP subcontractor scope and issue LOAs
- Lock IT infrastructure design: server room location, structured cabling backbone, Wi-Fi AP positions
Phase 5 — Construction & Installation (Weeks 8–14)
- Demolition and strip-out of redundant existing elements (if any)
- First-fix MEP: conduit, trunking, ductwork, pipework, cable trays
- Raised floor installation and/or screed works
- Stud partitioning, drylining, and acoustic insulation
- Suspended ceiling grid installation and integration with lighting and AC diffusers
- Second-fix MEP: devices, light fittings, FCU connections, plumbing fixtures
- Flooring: carpet tiles, LVT, polished concrete, or timber as per specification
- Joinery installation: reception desks, storage walls, kitchen units, feature panels
- Glazed partitions, manifestations, manifestation vinyl, and frameless door sets
- Specialist AV, video-conferencing, and building management system (BMS) integration
Phase 6 — Furniture, IT & Fit-Out Completion (Weeks 12–16)
- Deliver and install office furniture — workstations, chairs, collaborative seating, storage
- Complete IT infrastructure: patch panel termination, switch configuration, Wi-Fi commissioning
- Install signage, wayfinding, branded graphics, and manifestation
- Commission all MEP systems with test & commissioning certificates
- Civil Defense inspection and fit-out completion certificate
- Snagging: full joint inspection with contractor; issue snagging list
- Rectify all snags; obtain building management practical completion sign-off
- Hand over as-built drawings, O&M manuals, warranties, and spare parts

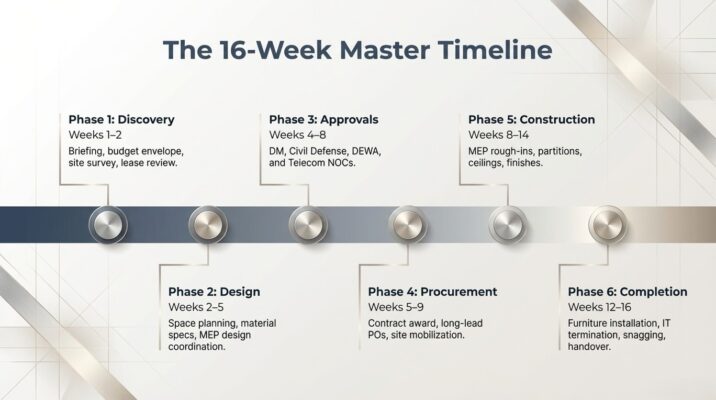

Project Timeline Breakdown — Typical Category B Fit-Out (1,000–2,000 Sq Ft)
| Phase | Key Activities | Duration | Milestone |
|---|---|---|---|
| Phase 1: Discovery | Brief, budget, site survey, RFP | Week 1–2 | Project Brief Approved |
| Phase 2: Design | Concept, space plan, material spec | Week 2–5 | Design Sign-Off |
| Phase 3: Approvals | DM / CD / DEWA / Telecom NOCs | Week 4–8 | All Permits Received |
| Phase 4: Procurement | Contract award, POs, mobilization | Week 5–9 | Site Mobilized |
| Phase 5: Construction | MEP, partitions, ceiling, finishes | Week 8–14 | Practical Completion |
| Phase 6: Completion | Furniture, IT, snagging, handover | Week 12–16 | Certificate Received |

4. Budgeting Your Office Fit-Out — Cost Benchmarks in AED
Accurate budgeting is the foundation of a successful office renovation UAE project. Costs vary significantly based on zone, specification level, and the chosen delivery model. The following benchmarks are derived from live market data across Dubai’s major commercial districts and are exclusive of VAT (5%).
| Cost Category | Budget Grade (AED/sq ft) | Mid-Range (AED/sq ft) | Premium Grade (AED/sq ft) |
|---|---|---|---|
| Demolition & strip-out | 10–20 | 20–35 | 35–60 |
| Partitioning & drylining | 25–50 | 50–90 | 90–160 |
| Ceilings (suspended / feature) | 20–45 | 45–80 | 80–180 |
| Flooring (carpet, LVT, timber) | 30–60 | 60–110 | 110–250 |
| MEP (mechanical, electrical, plumbing) | 50–90 | 90–160 | 160–280 |
| Joinery & bespoke millwork | 15–40 | 40–100 | 100–300 |
| Glazed partitions & doors | 20–50 | 50–100 | 100–220 |
| Lighting design & fixtures | 15–35 | 35–75 | 75–200 |
| IT infrastructure & AV | 20–50 | 50–100 | 100–250 |
| Office furniture (per workstation) | AED 1,500–3,000 | AED 3,000–6,000 | AED 6,000–18,000+ |
| Signage & branding | 5–15 | 15–35 | 35–80 |
| Authority fees & testing | 8–18 | 18–35 | 35–70 |
| Project management (% of works) | 8–10% | 10–12% | 12–15% |
| Contingency (recommended) | 10% | 10–12% | 12–15% |
Budget Rule of Thumb: For a mid-range Category B fit-out in Dubai, plan for AED 280–420 per sq ft (construction only). Add AED 60–120 per sq ft for quality office furniture Dubai specification, and 10–12% for project management and contingency.

5. Space Allocation Standards Per Employee — Dubai & UAE
International space benchmarks are shifting as agile working takes hold. The WELL Building Standard and BOMA guidelines recommend minimum net usable space per person. In the UAE context, the following figures are widely adopted by leading workspace planning Dubai consultants and reflect both local cultural preferences (privacy, hierarchy, hospitality) and global efficiency trends.

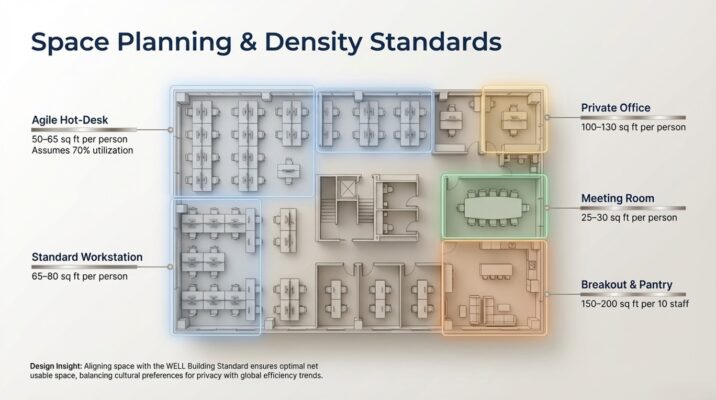

| Workspace Type | Recommended Sq Ft / Person | Notes |
|---|---|---|
| Open-plan workstation (standard) | 65–80 sq ft | Includes circulation, not shared zones |
| Open-plan workstation (agile hot-desk) | 50–65 sq ft | Assumes 70% desk utilisation ratio |
| Private office (junior manager) | 100–130 sq ft | Includes storage, chair for 1 visitor |
| Private office (senior manager) | 150–200 sq ft | Meeting table for 4 |
| Executive suite (Director / C-Suite) | 250–400 sq ft | Reception buffer, en-suite optional |
| Meeting room (per person) | 25–30 sq ft | e.g., 8-person room = 200–240 sq ft |
| Collaborative / lounge zone | 20–30 sq ft | Allocated across total headcount |
| Breakout / kitchen (per 10 staff) | 150–200 sq ft | Pantry, seating, fridge, dishwasher |
| Reception / lobby (per 50 staff) | 200–350 sq ft | Branded, with visitor seating |
| IT / server room (per 50 workstations) | 80–120 sq ft | Climate controlled, raised floor |
| Storage / filing | 10–15 sq ft / person | Centralized preferred over pedestals |

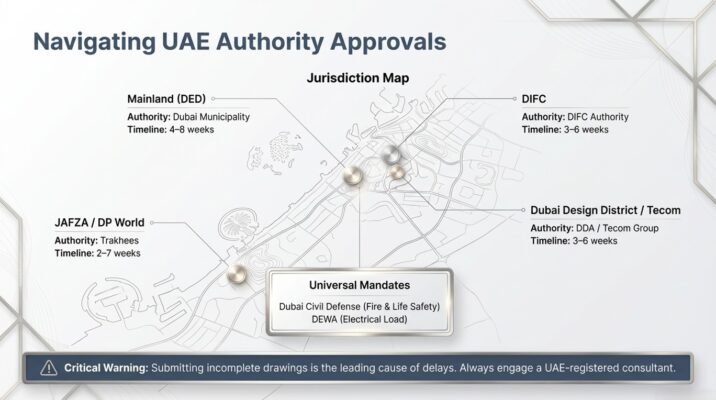

6. Authority Approvals Checklist — Dubai & UAE Free Zones
Navigating regulatory approvals is arguably the most complex element of any commercial fit-out Dubai project. The approving authority depends entirely on where your premises are located. The table below maps key jurisdictions to their approval bodies and indicative timescales.
| Jurisdiction / Location | Primary Approval Body | Typical Timeline | Key Submissions |
|---|---|---|---|
| Mainland Dubai (DED licensed) | Dubai Municipality — Building Permit | 4–8 weeks | NOC, fit-out drawings, structural calcs |
| DIFC (Financial Centre) | DIFC Authority (DIFCA) | 3–6 weeks | DIFCA NOC, CD approval, DEWA |
| Dubai Design District (d3) | Dubai Development Authority (DDA) | 3–6 weeks | DDA NOC, Civil Defense, Etisalat |
| Jebel Ali Free Zone (JAFZA) | JAFZA Authority | 2–5 weeks | JAFZA permit, CD, DEWA |
| DP World Zones (Port Rashid, etc.) | Trakhees | 4–7 weeks | Trakhees building NOC, CD |
| Tecom / Dubai Internet City / Media City | Tecom Group Authority | 3–6 weeks | Tecom NOC, DEWA, du telecom |
| Dubai Airport Free Zone (DAFZA) | DAFZA Permits Dept. | 2–4 weeks | DAFZA NOC, Civil Defense |
| Abu Dhabi (mainland) | Abu Dhabi City Municipality | 4–8 weeks | ADCE NOC, CD, ADDC/AADC |
| All locations — Fire & Life Safety | Dubai Civil Defense (DCD) | 3–6 weeks | Fire suppression, detection, escape routes |
| All locations — Electrical | DEWA (or zone authority) | 2–4 weeks | Load schedule, SLD, panel schedules |
| All locations — Telecom | du / Etisalat (e&) | 1–3 weeks | Cabling design, EPABX plan |
Important: Submitting incomplete or non-compliant drawings is the leading cause of approval delays. Always engage a UAE-registered consultant to prepare authority submissions — preferably one with an established relationship with the relevant authority.

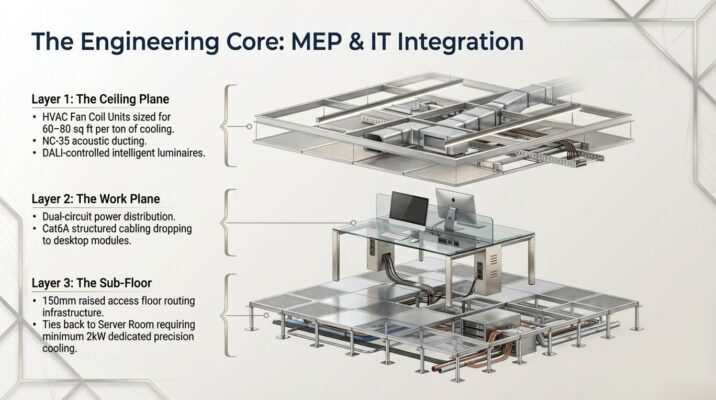

7. MEP Considerations — Mechanical, Electrical & Plumbing for Office Fit-Outs
MEP works are the backbone of any functional workplace and routinely account for 30–45% of total construction costs in a commercial fit-out Dubai project. Poor MEP coordination is the primary trigger for post-completion complaints acoustic failure, inadequate cooling, electrical outages, and plumbing leaks.
7.1 Mechanical — HVAC & Ventilation
Dubai’s climate demands best-in-class cooling. Most commercial buildings are served by central chilled water systems (District Cooling via Empower or building-level chillers), distributed via fan coil units (FCUs). Your fit-out must coordinate FCU positioning, fresh air quantities (minimum 10 L/s per person per ASHRAE 62.1), and supply/return duct routing with the building services engineer.
- Confirm chilled water flow rates allocated to your floor plate from the base building
- Size FCUs for occupancy density — open-plan offices are typically 60–80 sq ft per ton of cooling
- Incorporate dedicated fresh air units (FAUs) where base building supply is insufficient
- Design for acoustic performance — NC-35 in open plan, NC-30 in meeting rooms
- Install thermal comfort zones aligned to departmental / usage patterns
7.2 Electrical — Power, Lighting & Building Management
A typical Category B office requires 60–80W of connected load per sq ft (inclusive of HVAC). Confirm available load from the base building’s distribution board before finalizing your electrical design.
- Design power distribution for dual-circuit workstations (power + data) plus dedicated UPS circuits
- Ensure dedicated circuits for server room, AV systems, kitchen appliances
- Install smart lighting controls (DALI or KNX) to meet Dubai Green Building Regulations (DGBR)
- Incorporate metering at sub-panel level for energy monitoring and reporting
- EV charging provisions if ground floor or basement parking is part of your lease
7.3 Plumbing & Drainage
Office fit-out plumbing primarily covers kitchen/pantry areas, toilet facilities, and any specialized facilities such as prayer rooms with wudhu areas a cultural necessity in UAE workplace design.
- Design pantry drainage with grease traps if commercial-grade appliances are installed
- Wudhu area specification: non-slip tiling, stainless steel fixtures, dedicated hot/cold supply
- Inspect base building drain invert levels before routing new drainage — low slabs create significant constraints
- Coordinate fire suppression (sprinkler) modifications with the CD-approved contractor

8. IT Infrastructure Planning for Your Dubai Office
A modern office setup UAE demand that IT infrastructure is designed concurrently with architecture not retrofitted after construction. The cost of remediation (core-drilling finished floors, exposing ceilings) far exceeds early-stage investment in coordinated IT design.
8.1 Structured Cabling
- Specify Cat6A (minimum) for all data outlets — future-proofs for 10G to the desktop
- Design a centralized MDF / IDF strategy based on cable run lengths (max 90m horizontal)
- Plan for 2 data ports + 1 power outlet per workstation as a baseline
- Include dedicated cables for IP phones, VC cameras, door access readers, and CCTV
8.2 Server Room / IT Room Design
- Minimum 2kW dedicated cooling (precision AC unit or CRAC) per rack
- Raised floor (min 150mm) for cable management and under-floor cooling
- UPS with minimum 15-minute runtime at full load
- Dry pipe / inert gas fire suppression (NOT water sprinklers)
- Biometric or card-access entry; CCTV with 30-day NVR retention
8.3 Wireless & AV
- Conduct a wireless survey before AP placement — concrete columns and low-E glass cause significant dead spots in Dubai towers
- Specify enterprise-grade Wi-Fi 6E APs (e.g., Cisco Catalyst, Aruba, Juniper) for density and throughput
- Integrate AV: 4K displays, Zoom/Teams certified codecs, room booking panels (Crestron, Extron, QSC)
- IPTV / digital signage distribution for branded content in reception and breakout zones

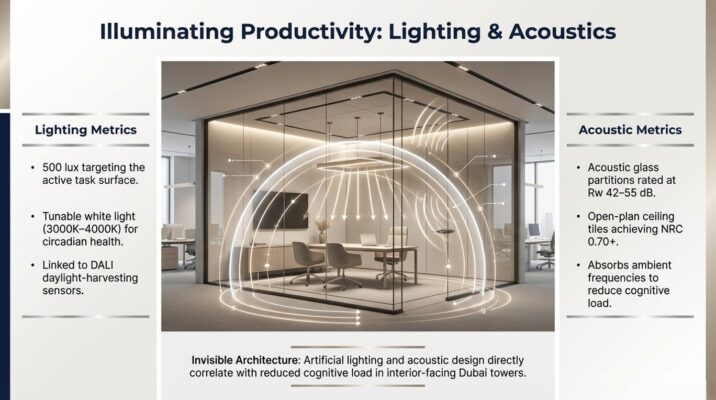

9. Lighting Design — A Critical Driver of Productivity and Wellbeing
Research published in the Journal of Environmental Psychology and WELL Building Standard literature confirms a direct correlation between lighting quality and cognitive performance, mood, and circadian health. In Dubai’s largely interior-facing offices particularly in towers where perimeter glazing is often limited by solar gain management artificial lighting design takes on heightened importance.
9.1 Illuminance Targets (Dubai Green Building Regulations)
| Zone | Recommended Lux Level | Colour Temperature | CRI |
|---|---|---|---|
| Open-plan workstations | 500 lux (task level) | 3500–4000K | ≥80 |
| Meeting rooms | 300–500 lux (adjustable) | 3000–4000K | ≥80 |
| Reception / lobby | 200–300 lux (ambient) | 2700–3000K | ≥80 |
| Breakout / lounge | 150–250 lux (relaxed) | 2700–3500K | ≥80 |
| Executive offices | 300–500 lux (layered) | 3000–4000K | ≥90 |
| Server / IT room | 500 lux (maintenance) | 4000–5000K | ≥70 |
| Prayer room | 200–300 lux (soft) | 2700–3000K | ≥80 |
| Corridors / circulation | 100–150 lux | 3500–4000K | ≥70 |
9.2 Smart Lighting Controls
- DALI-2 protocol for individual luminaire dimming and grouping
- Daylight-linked photocell sensors at perimeter zones to harvest natural light
- Occupancy sensors (PIR or ultrasonic) for automatic off/dim in unoccupied spaces
- Tunable white (2700–6500K) in focus rooms and executive zones for circadian support
- Emergency lighting: maintained / non-maintained as per Civil Defense specification

10. Workspace Ergonomics & Employee Wellbeing
Ergonomics in the modern UAE workplace transcends adjustable chairs. A truly ergonomic workspace planning Dubai strategy addresses posture, acoustics, thermal comfort, visual comfort, cognitive load, and the social dynamics of the team holistically. Forward-thinking companies are aligning their office interior design UAE with the WELL Building Standard (WELL v2) or the Fitwel framework.
10.1 Ergonomic Furniture Standards
Selecting the right office furniture is foundational. Premium office furniture Dubai suppliers offer height-adjustable desks (sit-stand), lumbar-supportive seating, and monitor arms that enable true postural neutrality. The minimum ergonomic specification for a contemporary UAE office should include:
- Height-adjustable workstations (min 650mm–1250mm range) — recommended for all knowledge workers
- Ergonomic task chairs: adjustable seat height, lumbar support, armrests, recline mechanism (e.g., from established office furniture collections available through OfficeMaster.ae)
- Monitor arms: maintain screen at arm’s length, top of screen at or just below eye level
- Under-desk cable management to eliminate floor-level trip hazards
- Acoustic privacy screens between open-plan workstations (min 600mm height above desk surface)
10.2 Acoustic Comfort
- Target NRC 0.70+ for open-plan ceiling tiles (e.g., Ecophon, Armstrong Ultima)
- Specify acoustic glass (Rw 42–55 dB) for meeting rooms — critical in Dubai towers with hard surfaces
- Install soft furnishings — fabric panels, lounge seating, rugs — in breakout zones
- Phone booths / pods for focused calls without disturbing open-plan colleagues
10.3 Biophilic Design
Biophilic design incorporating natural elements into the workplace is proving to be one of the highest ROI investments in office interior design UAE. Studies by Human Spaces indicate a 15% increase in wellbeing and an 8% increase in productivity in offices with biophilic elements.
- Living wall planters (moss walls or hydroponic vertical gardens) as reception focal points
- Potted tropical plants at workstation clusters — low maintenance with UAE climate compatibility
- Natural material accents: timber veneer, stone, linen, rattan in breakout and lounge zones
- Views of sky / water where possible — orient collaborative zones toward windows

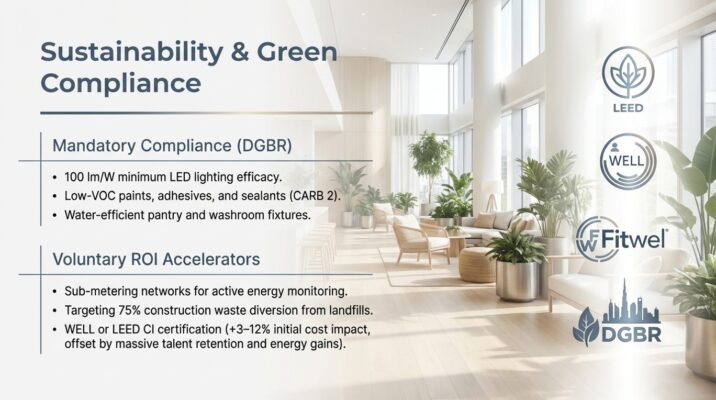

11. Sustainability & Green Building Compliance in Dubai
Dubai’s commitment to net-zero by 2050 enshrined in the Dubai 2040 Urban Master Plan and the UAE Net Zero by 2050 Strategic Initiative is cascading directly into commercial fit-out regulation. Dubai Green Building Regulations and Specifications (DGBR) are now mandatory for all new fit-out works above 500 sq ft in DM jurisdiction, and free-zone authorities are rapidly adopting equivalent standards.
11.1 Key Sustainability Measures for Office Fit-Outs
- LED lighting throughout minimum efficacy 100 lm/W; DALI controls mandatory above 1,000 sq ft
- Low-VOC paints, adhesives, and sealants (CARB 2 or better) — DGBR requirement
- Specify WELL-certified or Cradle-to-Cradle certified office furniture where budget allows
- Carpet tiles with recycled content (min 25%) and Red List chemical-free binders
- Water-efficient kitchen/pantry fixtures (WELS 3-star or equivalent)
- Sub-metering for energy monitoring — enables reporting against Dubai Carbon Abatement Strategy targets
- Construction waste management plan — target 75% diversion from landfill (LEED CI standard)
11.2 Green Certifications Available in Dubai
| Certification | Scope | Typical Cost Impact | Authority Recognition |
|---|---|---|---|
| LEED CI (v4.1) | Interior & construction | +3–8% on fit-out cost | DM, DDA, DIFC — widely recognized |
| WELL v2 | People & health focus | +5–12% on fit-out cost | Growing recognition across UAE |
| Fitwel | Wellbeing framework | +2–5% on fit-out cost | Emerging in UAE free zones |
| BREEAM In-Use | Building & occupier | +3–7% on fit-out cost | Recognized — Abu Dhabi / ADNOC |
| Dubai Green Building Reg. | Mandatory compliance | Nil if planned from outset | Mandatory — Dubai Municipality |
12. Selecting the Right Fit-Out Contractor in Dubai
The contractor you appoint will make or break your project. Dubai’s fit-out market is large, diverse, and uneven in quality. Use the following criteria to objectively evaluate and compare proposals from commercial fit-out Dubai firms.
12.1 Contractor Evaluation Scorecard
| Evaluation Criterion | Weight | What to Look For |
|---|---|---|
| Relevant portfolio & case studies | 20% | Office projects in your sector and scale, post-COVID completions |
| Technical team qualifications | 15% | Registered engineers (DM/free zone), LEED AP, WELL AP credentials |
| Authority approval track record | 15% | Documented NOC success rate; ask for approval letters |
| Financial stability | 10% | 2+ years audited accounts; Performance Bond capability |
| Health, Safety & Environment (HSE) | 10% | OHSAS 18001 / ISO 45001 certification; accident frequency rate |
| MEP in-house vs subcontracted | 10% | In-house preferred for accountability; vet named subcontractors |
| Transparency of pricing | 10% | Detailed BoQ vs lump sum; clear provisional sums |
| Post-completion support & warranty | 10% | Min 12-month defects liability; dedicated maintenance team |

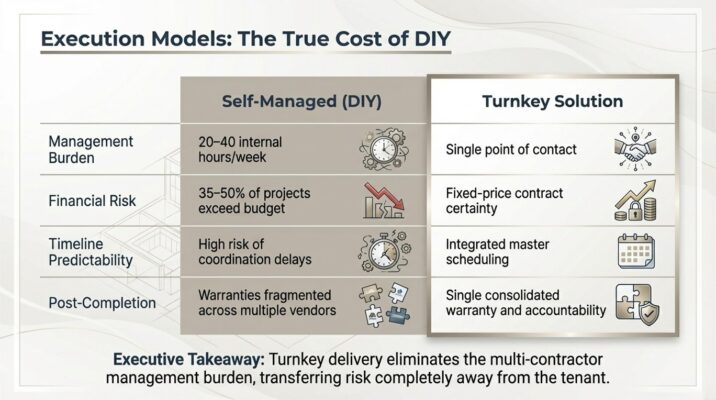

12.2 DIY Fit-Out vs. Turnkey Solution — Detailed Comparison
| Aspect | Self-Managed (DIY) | Turnkey Office Solutions Dubai |
|---|---|---|
| Internal management effort | Very high — 20–40 hrs/week | Low — single point of contact |
| Risk of cost overruns | High (35–50% projects exceed budget) | Low (fixed price contract) |
| Design quality control | Variable (multiple designers/contractors) | Consistent (single D&B team) |
| Authority approval management | Tenant responsible | Contractor responsible |
| Timeline predictability | Low — coordination delays common | High — integrated scheduling |
| Furniture procurement | Tenant manages 3–5 suppliers | Included in single contract |
| Suitability | Experienced property teams, large corporates | SMEs, start-ups, regional HQs |
| Warranty & aftercare | Fragmented (multiple warranties) | Single warranty / single contact |

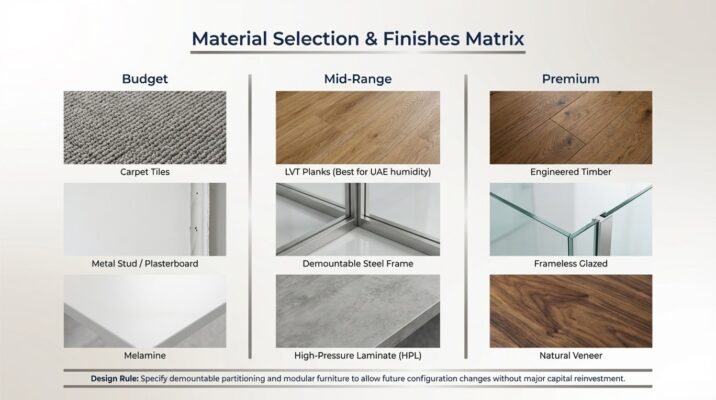

13. Materials Comparison — Making Informed Specification Decisions
| Material Category | Budget Option | Mid-Range Option | Premium Option | Key Consideration |
|---|---|---|---|---|
| Flooring | Carpet tiles (loop pile) | LVT / LVP planks | Engineered timber / polished concrete | LVT best for durability in Dubai humidity |
| Partitioning | Metal stud / plasterboard | Demountable steel frame | Full-height glazed (frameless) | Demountable = future flexibility |
| Ceiling | Standard mineral tiles (600×600) | Lay-in metal tiles | Bespoke timber / GRG cloud | Check base building void height (min 200mm) |
| Workstation surface | Melamine laminate | High-pressure laminate (HPL) | Solid surface / natural veneer | HPL most durable for UAE heat |
| Reception desk | Off-the-shelf modular | Semi-bespoke joinery | Full bespoke with stone / metal | Allow 6–8 weeks for bespoke |
| Acoustic panels | Polyester wadding behind fabric | Perforated MDF baffle | Factory-finished wool fabric tile | Target NRC 0.80+ for open offices |
14. Post-Installation Evaluation — Making Sure Your Fit-Out Delivers
A fit-out is not complete at handover. Leading organizations conduct a formal Post-Occupancy Evaluation (POE) 4–6 weeks after move-in to validate that the space performs as designed and to identify any ergonomic, environmental, or operational issues before the Defects Liability Period (DLP) expires.
Post-Occupancy Evaluation Checklist
- Thermal comfort survey: Are all zones hitting 21–24°C? Are there hot spots near glazing?
- Lighting assessment: Measure task illuminance with a calibrated lux meter against design targets
- Acoustic measurement: Check NRC against spec; identify any HVAC noise complaints
- IT performance: Wi-Fi throughput test per zone; VoIP call quality assessment
- Furniture ergonomics: Are sit-stand desks being used? Is chair adjustment guidance provided?
- Energy benchmarking: Compare kWh/sq ft to pre-fit-out baseline and DGBR targets
- Occupancy vs. utilization: Are meeting rooms over/under-subscribed? Adjust booking policies
- Staff satisfaction survey: Anonymous feedback on space, comfort, and collaboration
- Snagging close-out: Confirm all DLP items formally resolved and signed off
- Warranties log: Compile all product and systems warranties in a single managed register
Frequently Asked Questions — Office Fit-Out Dubai
Q: How long does an office fit-out take in Dubai?
A typical Category B office fit-out in Dubai takes 10–16 weeks from design sign-off to handover for spaces between 1,000–3,000 sq ft. Larger or more complex projects (5,000+ sq ft with extensive bespoke joinery and full MEP redesign) can take 20–28 weeks. The authority approval phase — typically 4–8 weeks — is usually the longest single bottleneck and should be initiated as early as possible, ideally concurrently with detailed design.
Q: What is the average cost of an office fit-out in Dubai?
Mid-range Category B fit-outs in Dubai average AED 280–420 per sq ft for construction works alone. Add AED 80–150 per sq ft for quality office furniture Dubai selections, authority fees, project management, and a 10–12% contingency. Premium-grade fit-outs in DIFC, Downtown, or DWTC can reach AED 600–900 per sq ft all-in. Budget-grade fit-outs are possible at AED 150–220 per sq ft but involve significant compromises in materials, acoustics, and flexibility.
Q: Do I need Dubai Municipality approval for my office fit-out?
Yes — if your premises are in mainland Dubai under a DED trade license, you require a building permit and fit-out NOC from Dubai Municipality. If your premises are in a free zone (DIFC, JAFZA, Tecom, DDA, Trakhees, etc.), you require the approval of that specific authority. Civil Defense approval for fire and life safety is mandatory in all jurisdictions. Non-compliance can result in stop-work orders and mandatory demolition.
Q: What is the difference between Category A and Category B fit-out?
Category A refers to the base level of fit-out provided by a landlord, transforming a raw shell space into a lettable but unoccupied unit — typically including raised floors, suspended ceilings, and basic MEP services. Category B is the tenant’s fit-out that makes the space functional and branded: partitioned rooms, joinery, office furniture, IT, lighting design, and all the elements that reflect the company’s identity and working style.
Q: What is a turnkey office solution in Dubai?
A turnkey office solution Dubai is a single-contract delivery model where one firm manages the entire fit-out journey — from initial concept and space planning through design, authority approvals, construction, MEP, IT infrastructure, and furniture installation — handing the client a fully operational, move-in-ready workspace. It eliminates the multi-contractor management burden and provides fixed-price cost certainty.
Q: How do I choose an office fit-out contractor in Dubai?
Evaluate contractors on five key criteria: relevant portfolio (office projects of similar scale), registered authority relationships (proven NOC track record), financial stability (performance bond capability), in-house MEP or vetted subcontractors, and post-completion warranty support. Always obtain at least three proposals against an identical scope of work and BoQ to enable like-for-like comparison. Avoid selecting on price alone — quality variation in Dubai’s fit-out market is significant.
Q: How much space does each employee need in a Dubai office?
The standard benchmark for open-plan workstations is 65–80 sq ft (net usable) per person, excluding shared zones like meeting rooms, reception, and kitchens. With shared facilities included, the gross space allocation typically rises to 100–130 sq ft per person. Agile hot-desking strategies — with a 70% utilization ratio — can reduce net desk space to 50–65 sq ft per person, freeing up floor plate for collaboration zones.
Q: What MEP works are required in an office fit-out?
Office fit-out MEP works typically include: HVAC modifications (FCU repositioning, ductwork, fresh air), electrical works (power distribution, lighting circuits, sub-panels), data and telecom first-fix cabling, fire suppression modifications (sprinkler heads), fire detection and alarm integration, plumbing for kitchen/pantry and wudhu areas, and building management system (BMS) integration. MEP works require approval from DEWA, Civil Defense, and the relevant telecom authority.
Q: Are sit-stand desks worth it in a Dubai office?
Yes — height-adjustable desks deliver measurable benefits. WELL Building Standard research cites reduced musculoskeletal complaints, improved energy levels, and higher engagement scores in offices with sit-stand desks. In Dubai’s extended working hours culture, where back pain and fatigue are common employee health concerns, ergonomic investment delivers a rapid return through reduced sick leave and higher retention. OfficeMaster.ae office furniture range includes premium sit-stand solutions at competitive UAE market prices.
Q: What sustainable features should I include in my Dubai office fit-out?
Mandatory under Dubai Green Building Regulations: LED lighting (min 100 lm/W), daylight sensors at perimeter zones, low-VOC finishes, and water-efficient fixtures. Strongly recommended: sub-metering for energy monitoring, carpet tiles with recycled content, demountable partitioning for long-term flexibility, and biophilic design elements. Optional but high-ROI: WELL or LEED certification, tunable white lighting for circadian health, and EV charging provision.
Q: Can I fit out a free zone office differently from a mainland office?
Yes — each free zone authority has its own design guidelines, permitted materials list, and fit-out procedures. DIFC, for example, mandates specific fire door specifications and requires DIFCA-approved contractors. JAFZA has strict structural and MEP submission requirements. Always obtain the authority’s specific fit-out guide at the outset of your project. A contractor experienced in the relevant zone is invaluable in accelerating approvals.
Q: What is the defects liability period for office fit-outs in Dubai?
The standard Defects Liability Period (DLP) in UAE commercial construction contracts (based on FIDIC or CIOB frameworks) is 12 months from Practical Completion. Some bespoke joinery and specialist MEP items carry manufacturer warranties of 3–5 years. Ensure your contract clearly defines the DLP, the notification procedure for defects, and the contractor’s obligation to rectify within a defined timeframe. Extended DLP of 18–24 months is increasingly offered by premium fit-out contractors as a market differentiator.
Q: What is the best layout for a modern Dubai office?
The most effective layout for contemporary UAE businesses is an activity-based working (ABW) hybrid: open-plan workstations with bench-style or height-adjustable office furniture for focused individual work, supported by a diverse range of collaboration zones — small huddle rooms, medium meeting rooms, large boardrooms, and informal lounge areas. Supplement with acoustic pods for private calls and focus work. Cultural considerations in the UAE include dedicated prayer rooms, gender-separated facilities, and executive offices that signal hierarchy — balance these with the openness the modern workforce expects.
Q: How do I plan IT infrastructure for a new Dubai office?
Begin with a network design workshop: agree on server room location, internet service providers (du or Etisalat), and bandwidth requirements before construction starts. Specify Cat6A minimum for all data cabling. Design Wi-Fi coverage with enterprise APs (minimum 1 per 1,500 sq ft in open plan). Include CCTV, access control, and audio-visual systems in the IT scope. Commission a structured cabling contractor registered with the relevant telecom authority for permit compliance.
Q: How much does office furniture cost in Dubai?
Office furniture Dubai costs vary widely by specification. A basic workstation (desk + pedestal + task chair) starts at around AED 1,500–2,500. Mid-range ergonomic specifications — height-adjustable desk, premium task chair, monitor arm — range from AED 3,500–7,000 per workstation. Executive and bespoke boardroom furniture can run AED 15,000–60,000+ per suite. OfficeMaster.ae offers a curated range of office furniture solutions across all price points, backed by ergonomic expertise and UAE-wide delivery and installation.
Expert Planning Guide — The 10 Golden Rules for a Successful Dubai Office Fit-Out
- Plan before you sign the lease. Conduct a space feasibility study before committing to a floor plate. The cheapest rent per sq ft is worthless if the space cannot be efficiently fitted out for your operational model.
- Appoint your fit-out consultant on Day 1. The right workspace planning Dubai partner will identify structural constraints, authority requirements, and cost risks before your lease clock starts ticking.
- Build authority approvals into your programmed not as an afterthought. Submit early, submit correctly, and appoint a contractor with an established relationship with the relevant authority.
- Invest in MEP coordination. Uncoordinated services are the number one source of construction delays and post-occupancy complaints. Mandate a BIM (Building Information Modelling) clash detection review before construction begins for projects above 3,000 sq ft.
- Don’t underestimate the power of office furniture. The best architectural shell is let down by poor-quality, ill-specified office furniture. Invest adequately in ergonomic, durable, and brand-appropriate solutions — your team will spend 8+ hours a day using them.
- Design for flexibility. Dubai’s business environment moves fast. Specify demountable partitioning, modular office furniture systems, and raised access flooring to allow configuration changes without major reinvestment.
- Protect your budget with a 10–15% contingency. Even the most meticulously planned office renovation UAE project encounters unforeseen conditions. Contractual surprises, latent defects in the base building, and scope creep are inevitable without a managed reserve.
- Consider sustainability from the outset, not as a retrofit. Dubai Green Building Regulation compliance is mandatory; aiming for LEED or WELL certification adds incremental cost but delivers long-term energy savings and talent attraction benefits that outweigh the premium.
- Conduct a Post-Occupancy Evaluation. The data gathered 4–8 weeks after move-in is the most valuable input for your next office project — and resolves lingering defects while the contractor’s warranty is still active.
- Choose partners, not just vendors. The most successful office fit-out Dubai projects are built on long-term relationships with fit-out firms who understand your business, your brand, and your people — not merely the cheapest quotation on a given day.

Your Dubai Office Fit-Out Starts Here
A high-performance workspace in Dubai is not a luxury it is a strategic asset. It attracts and retains the best talent in one of the world’s most competitive hiring markets, projects your brand with authority to every client, partner, and stakeholder who walks through the door, and drives the kind of day-to-day productivity that compounds into measurable commercial outcomes.
From initial discovery and authority approvals through MEP coordination, smart lighting design, ergonomic office furniture specification, IT infrastructure, sustainability compliance, and post-occupancy evaluation — every element of this guide is designed to help you make faster, smarter, more confident decisions across your entire office fit-out journey in Dubai and the wider UAE.
The brands and businesses that consistently deliver outstanding workplaces do not do it alone. They partner with experienced, accountable, and creative commercial fit-out Dubai specialists who bring technical excellence, authority relationships, and genuine design intelligence to every project.
Ready to Transform Your Dubai Workspace?
OfficeMaster.ae is the UAE’s trusted partner for end-to-end office fit-out, workspace planning, and premium office furniture Dubai solutions. From agile start-up environments to multi-floor corporate headquarters, our team of certified designers, project managers, and MEP engineers delivers turnkey office solutions Dubai businesses rely on on time, on budget, and built to last.
Contact OfficeMaster.ae today for a complimentary workspace consultation and no-obligation fit-out quote. Your new office begins with a single conversation.
